What Does a BIM Consultant Do for an Architect or Engineer in Singapore? (2025)
Published on

What Does a BIM Consultant Do for an Architect or Engineer in Singapore? (2025)

A BIM consultant engaged by an architect or engineering consultant is responsible for governance of the design-stage BIM workflow and authority submissions — not construction delivery. The role centres on three things: preparing the EIR to contractually lock down contractor BIM obligations, managing the CORENET X Design Gateway submission as the QP's technical representative, and coordinating discipline models to a standard that survives handover to the construction team.

This is structurally different from a BIM consultant engaged by a main contractor. The design consultant's BIM engagement starts before tender — before the contractor even exists — and the most consequential decision in the entire project BIM programme happens at this stage: what goes into the EIR.

BIM Consultant vs In-House BIM Coordinator: What's the Difference?

These roles are frequently conflated. On a small practice both may be the same person. On larger projects they are distinct.

A BIM coordinator is typically in-house — responsible for day-to-day model production oversight, software management, and keeping the design team's models current. They are embedded in production.

An external BIM consultant provides what the in-house team cannot: independent quality assurance, specialist authority submission support, and strategic BIM governance that sits above the production workflow. On a design consultant project, the consultant also authors the EIR — which is a strategic and legal document, not a production task.

The key distinction from a main contractor engagement: on a design consultant project, the BIM consultant is engaged before tender. The EIR they write shapes what the contractor must deliver. That leverage does not exist once the contract is awarded without one.

Full Scope of Responsibilities

a. BIM Planning & Setup

EIR Authoring — The Most Important Thing a Consultant Does

The Employer's Information Requirements is the document that defines what BIM information the main contractor must produce, at what LOD, and at what project milestone. If the architect does not author a rigorous EIR before tender, the default is that the contractor's BEP governs — and contractors will minimise BIM scope wherever the contract is silent.

A well-drafted EIR should require at minimum:

  • Construction BIM model at LOD 350 from the main contractor and major subcontractors
  • As-built BIM model at LOD 500 with FM data, submitted at Completion Gateway
  • Named CDE platform and ISO 19650-compliant workflow
  • Clash-free federated model before construction commences
  • Monthly BIM audit reports submitted to the consultant and employer

This pushes the cost of construction and as-built BIM modelling into the main contractor's contractual scope — not the design team's. The most common failure on Singapore building projects is not a bad BIM model at design stage; it is arriving at handover with no as-built BIM model at all, because no one required it in the contract. Authoring the EIR properly is how you prevent that. See our BEP template guide for what a compliant BEP response to a strong EIR looks like.

BEP Preparation — The Consultant's Own BEP

The design consultant also authors their own BEP covering the design-phase BIM delivery. This is separate from the EIR. The pre-contract BEP is issued at tender stage covering the consultant's BIM delivery approach; the post-contract BEP is finalised after appointment and covers software, CDE, and the LOD/LOI matrix for design disciplines only.

At design stage, subcontractor models do not yet exist. The LOD matrix covers architectural, structural, and M&E design intent — typically LOD 200–300 — not construction or fabrication models.

LOD/LOI Matrix for Design Stage

The Design Gateway requires LOD 200–300 depending on discipline and element. This is materially different from what the main contractor must deliver: construction models require LOD 300–350; as-built models require LOD 500.

LOI at design stage focuses on the IFC+SG parameters required by BCA and URA for planning approval: room classifications and GFA calculations. A model that is geometrically complete at LOD 300 but missing these parameters will fail Design Gateway validation. The consultant defines the LOI matrix and is accountable for verifying compliance before submission. For a detailed breakdown, see our BIM LOD guide.

BIM Standards, Naming Conventions, CDE Setup

The consultant establishes the project's file naming convention (ISO 19650), workset structure, and CDE folder hierarchy. A standard naming pattern for a Singapore design project might follow:

[ProjectCode]-[Discipline]-[Stage]-[Version]-[Date].rvt

For example: PROJ2025-AR-DG-01-20250401.rvt

CDE folder structure for design stage covers four states: WIP → Shared → Published → Archive. Revision workflow should align to QP submission milestones so the published model and the submitted model are always the same file.


b. CORENET X Design Gateway — The Core Deliverable

For a design consultant, the Design Gateway is the primary submission milestone. This is different from a main contractor engagement, where the Construction Gateway carries more production risk. For the design team, getting the Design Gateway right is the key deliverable.

Who Submits? The QP / Project Coordinator Role

The Qualified Person — the registered architect or engineer — is legally accountable for the submission. On most mixed-use and residential projects in Singapore, the QP Architect acts as Project Coordinator for multi-agency submissions. For structural-only A&A works, the QP Engineer may be the Project Coordinator.

The BIM consultant's practical role: prepare, validate, and upload the model. The QP reviews and endorses. The consultant is accountable for model quality; the QP is accountable for compliance with design codes.

Design Gateway: What Is Actually Required

  • Federated model in IFC+SG format
  • LOD 200–300 for architectural, structural, and M&E design intent
  • IFC+SG property sets required by BCA and URA: room classifications and GFA parameters
  • Design team models only — no subcontractor models required at this stage
  • Multi-agency consolidated review by BCA, URA, NEA, LTA, and PUB within 20 working days

This is different from the Construction Gateway, which requires LOD 350 and clash-free coordination across subcontractor fabrication models. At Design Gateway, the obligation is design intent with correct regulatory parameters — not construction-ready fabrication geometry.

Pre-Submission QA

Before any model is submitted, the consultant runs a multi-stage QA check:

  1. Geometry checks — spatial validation, GFA calculation cross-check against design intent, duplicate element detection
  2. Parametric checks — IFC+SG parameter completeness for all regulatory elements
  3. Agency-specific checks — URA plot ratio compliance, NEA setbacks, BCA GFA classification

Typical unvalidated models contain hundreds of IFC+SG parameter errors. Each error requires manual correction, and a full error log can take days to resolve without proper tooling. The Bimeco Validator provides free IFC+SG parameter checking specifically for CORENET X submissions — use it before submitting. Read the Validator guide and see how automated checks work.

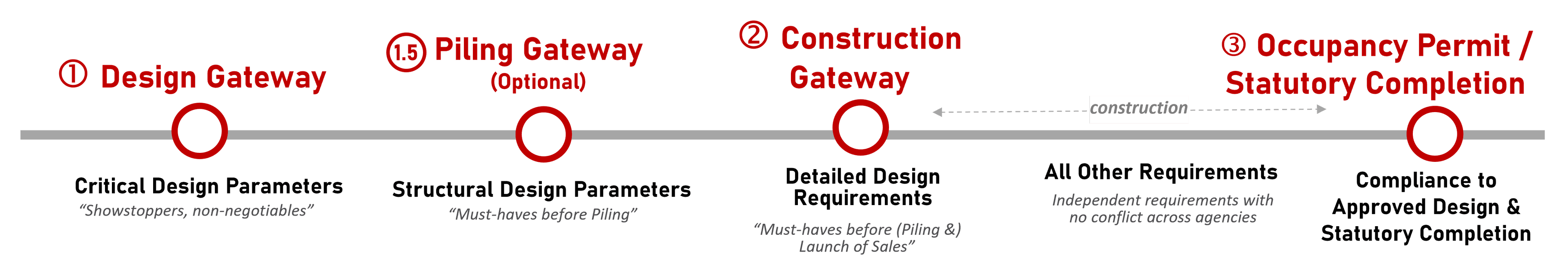

CORENET X Gateway Reference

GatewayStageLOD RequiredWho Submits
Design GatewayPlanning / design approval200–300QP Architect / Project Coordinator
Piling GatewayFoundation works approvalStructural model with pile layoutQP Engineer
Construction GatewayBuilding works permit300–350, clash-free, subcontractor modelsMain Contractor's BIM team
Completion GatewayTOP / CSC application500 as-built, FM dataMain Contractor's BIM team

The design consultant is responsible for the first two rows. The contractor's BIM team (with their own BIM consultant) handles the last two.


c. Multi-Discipline Design Coordination

Inter-Discipline Clash Detection at Design Stage

At design stage, clashes are between architectural, structural, and M&E design intent models — not subcontractor fabrication models. These clashes are cheaper to resolve now than during construction, but they are routinely ignored without a consultant to enforce the process.

Typical tools: Navisworks, BIMcollab Zoom, Solibri. The consultant runs clash detection across the federated design model, maintains the clash register, and chairs coordination sessions to drive resolution. Our ICE session guide covers the meeting workflow and tooling.

Coordination with Multiple Engineering Consultants

On a typical project the architect coordinates three to five engineering consultants — C&S, M&E, FSSD, geotechnical, and sometimes specialist trade consultants. Each produces their own discipline model. The BIM consultant sets the federated model workflow, chairs coordination sessions, and maintains the clash register.

The unique challenge at design stage that does not exist at construction stage: models are works-in-progress and change frequently. Version control is critical. Every session, the consultant must confirm which model version is current before running clash detection — using a stale model produces a meaningless clash report.


d. Tender Documentation — Setting Up the Main Contractor for BIM Success

This section has no equivalent in the main contractor's BIM consultant scope. It is unique to the design consultant engagement, and it is where the most long-term value is created.

BIM Requirements in Tender Documents

The BIM consultant should ensure that BIM requirements are embedded in the tender documents before the main contractor is appointed. Specifically:

  • The EIR included as a formal contract document
  • BIM model deliverables listed as contract obligations (not just aspirations)
  • Penalties or stage payments tied to BIM milestone delivery

If BIM requirements are not in the tender, the contractor has no contractual obligation to deliver a construction or as-built BIM model. This is the single most common failure point on Singapore building projects. The architect delivers a design BIM model. The contractor builds from 2D drawings. At handover, there is no as-built BIM model for the building owner — because no one required it in the contract.

What the EIR Should Require from the Contractor

At minimum, a well-drafted EIR should require the following from the main contractor:

  • Construction BIM model (all disciplines, LOD 350) — main contractor's scope, not design consultant's
  • Subcontractor BIM models (structural, M&E) — subcontractor scope, coordinated by the main contractor
  • As-built BIM model (LOD 500 with FM data) — main contractor's scope, submitted at Completion Gateway
  • Named CDE platform with ISO 19650-compliant workflow throughout construction
  • Monthly BIM audit reports submitted to the design consultant or employer's representative

Getting this into the tender documents is what separates a design consultant who leaves behind useful long-term asset data from one who delivers a design model and hands over nothing the building owner can use for maintenance or future works. For the contractor's perspective on receiving and responding to an EIR, see our companion article on BIM consultancy for main contractors.


e. Quality & Compliance

Ongoing Model Audits During Design Development

The consultant conducts monthly QA audits against the BEP covering: LOD compliance by discipline, IFC+SG parameter population, CDE workflow adherence, and submission readiness against the programme. Audit reports are submitted to the QP and, where required, to the employer's representative.

Audits create an evidence trail. If a discipline consultant later disputes whether their model met the agreed standard, the audit log provides an objective record. This matters particularly when CORENET X rejects a submission and there is a question of which discipline's model caused the failure.

RFI and Design Change Management

Design changes are routine. Each one creates a risk of model-drawing divergence — where the drawing is updated but the model is not, or vice versa. The consultant links design change instructions to relevant model elements in the CDE and ensures the model is updated before re-submission at each gateway. This prevents arriving at Design Gateway with a model that does not match the current design drawings.


What Is NOT Included in BIM Consultancy Scope

The same principle applies here as for main contractor engagements. A BIM consultant does not:

  • Develop 3D models for any discipline — that is the design team's modellers
  • Prepare construction drawings or specifications
  • Act as QP or take legal responsibility for design compliance — the QP retains this
  • Manage the construction BIM process — that is the contractor's BIM consultant's scope after contract award

If a design practice expects the BIM consultant to also produce models, that is a separate scope priced as BIM modelling services. Conflating the two leads to scope creep and under-scoped consultancy fees.


How This Differs from a BIM Consultant Engaged by the Main Contractor

AspectArchitect / Consultant EngagementMain Contractor Engagement
When engagedPre-design / pre-tenderPost-contract award
Primary submissionDesign Gateway (LOD 200–300)Construction + Completion Gateway (LOD 350–500)
Models coordinatedDesign team disciplines onlyDesign + subcontractor fabrication models
EIRAuthors itResponds to it (via BEP)
Clash detection focusDesign intent conflictsFabrication / installation conflicts
Key risk managedRegulatory rejection at Design GatewayRework on site from unresolved clashes
4D / 5D / 6D BIMNot in scope at design stageFull section — construction programme, QS, FM
QP relationshipWorks for / supports the QPLiaises with the QP

For the full scope of what a BIM consultant does post-contract for the main contractor, see What Does a BIM Consultant Do for a Main Contractor?


Singapore Regulatory Context — Design Consultants

BCA BIM Mandate: BIM is mandatory for all new building projects above 5,000 sqm. From 1 October 2026, all new building projects require BIM submission via CORENET X — covering all building types across commercial, industrial, institutional, and residential sectors.

CORENET X: Requires 3D BIM models in IFC+SG format. IFC+SG is an extension of the IFC4 schema with Singapore-specific property sets required by BCA, URA, NEA, LTA, and PUB. For design consultants, the Design Gateway is the primary obligation. For the full submission framework, see our CORENET X guide for Singapore.

QP Obligations: The registered architect or engineer acting as QP is legally accountable for CORENET X submissions. The BIM consultant provides technical preparation and validation; the QP endorses and submits. The QP cannot delegate their legal accountability — only the technical workload.

IDD Framework: Design consultants are the upstream participants in Singapore's Integrated Digital Delivery framework. BCA's IDD initiative encourages design teams to produce BIM models that integrate with downstream construction workflows — not just models designed for authority submissions. Learn more about IDD and how design-stage BIM quality affects construction delivery.

For pre-submission IFC+SG validation, the Bimeco Validator provides free parametric checks, bulk editing, and 3D visualisation. Read the Validator guide.


Glossary of Key BIM Terms

EIR (Employer's Information Requirements): The document specifying what BIM information must be produced, at what LOD, and delivered at what milestone. For design consultants, authoring the EIR before tender is the most important BIM governance action on the project — it determines whether the contractor is contractually obligated to deliver construction and as-built BIM.

QP (Qualified Person): The registered architect or engineer legally accountable for CORENET X submissions and design compliance. The QP endorses BIM submissions but can delegate technical preparation to the BIM consultant.

Project Coordinator: The QP designated to coordinate multi-agency submissions via CORENET X. Typically the QP Architect on mixed-use and residential projects.

Design Gateway: The CORENET X submission stage for planning and design approval, requiring LOD 200–300 IFC+SG models from the design team. This is the primary submission milestone for an architect or engineering consultant.

LOD (Level of Development): A scale (100–500) defining the geometric and data completeness of a BIM element. LOD 200–300 is required at Design Gateway; LOD 350 for construction; LOD 500 for as-built.

LOI (Level of Information): The non-geometric data embedded in each BIM element. At design stage, LOI covers IFC+SG parameters required for regulatory approval — room classifications and GFA.

BEP (BIM Execution Plan): The governing document for the project's BIM delivery. The design consultant produces their own BEP for design-phase delivery. The EIR is a separate document — it defines what the contractor must deliver.

CORENET X: Singapore's multi-agency electronic platform for building plan approvals, requiring 3D BIM models in IFC+SG format. Mandatory for all new building projects from 1 October 2026.

IFC+SG: Singapore's extension of the IFC4 open BIM standard, adding property sets required by local regulatory agencies. Required for all CORENET X submissions.

Clash Detection: The automated process of identifying geometric conflicts between discipline models in a federated BIM model. At design stage, clashes are between design intent models. At construction stage, clashes are between fabrication models.


About Bimeco

Bimeco is Singapore's leading BIM service provider, delivering end-to-end digital delivery and BIM compliance services for asset owners, consultants, and contractors across the AEC industry. We provide BIM consultancy across architectural, structural, and MEP disciplines, and have supported CORENET X Design Gateway submissions for commercial, mixed-use, and institutional projects in Singapore.

Our services include BIM consultancy and governance, EIR authoring, CORENET X submission support, clash detection and coordination, and IDD implementation. Ivan Tang (Director, Digital Solutions) leads our technical team and can be reached at enquiry@bim.com.sg.

For architects, engineers, and design consultants preparing for BIM requirements or CORENET X submissions, contact our team to discuss scope and pricing. You can also learn more about our BIM for architecture services and BIM consulting services.

Frequently Asked Questions

A BIM consultant engaged by an architect or engineering consultant manages the design-stage BIM workflow and authority submissions. The core responsibilities are authoring the Employer's Information Requirements (EIR) before tender, preparing and validating the CORENET X Design Gateway submission, coordinating discipline models across the design team, and setting up the BIM governance framework that the main contractor will later respond to. The consultant does not develop models directly — that is the design team's responsibility.
The Qualified Person (QP) — typically the registered architect or engineer — is legally accountable for CORENET X submissions. On most mixed-use and residential projects, the QP Architect acts as Project Coordinator for multi-agency Design Gateway submissions. The BIM consultant's role is to prepare, validate, and upload the model; the QP reviews and endorses it. The consultant is accountable for model quality; the QP is accountable for design code compliance.
The Design Gateway requires LOD 200–300 depending on discipline and element type. Architectural elements typically require LOD 300 for planning approval purposes; structural and M&E design intent models are acceptable at LOD 200–250 at this stage. Critically, the LOD requirement is separate from the LOI requirement — a model that is geometrically complete at LOD 300 but missing IFC+SG parameters (room classifications, GFA parameters, accessibility compliance data) will fail Design Gateway validation regardless of geometric completeness.
An EIR (Employer's Information Requirements) is the document that defines what BIM information the main contractor must produce, at what LOD, and at what project milestone. If the architect does not author a rigorous EIR before tender, the contractor's BEP governs by default — and contractors will minimise BIM scope. A well-drafted EIR pushes the cost of construction BIM and as-built modelling (LOD 350–500) into the main contractor's contractual scope. This is the single most effective action a design consultant can take to protect the employer's long-term asset data interests.
At design stage, the consultant manages BIM requirements for the design team disciplines only — architecture, structure, and M&E design intent. Subcontractor models do not yet exist. The consultant's key role is to embed BIM obligations for the main contractor and subcontractors into the tender documents and EIR before the contractor is appointed. Once the contractor is on board, their BIM consultant (not the design consultant) manages subcontractor coordination for construction. If the design consultant's EIR is weak, there is no contractual basis to demand a construction or as-built BIM model at handover.
BIM consultancy for a design consultant engagement typically runs at $6,000–$10,000 per month for strategic governance, EIR authoring, Design Gateway submission support, and ongoing coordination oversight. The design-stage engagement is usually shorter than a main contractor engagement (12–18 months vs 24–36 months), reflecting the lower model production volume at design stage. Costs scale with project complexity, number of design disciplines, and whether the scope includes full CORENET X submission management or advisory support only.

Authors

Ivan Tang
Director, Digital Solutions

Work with Qualified BIM Consultants Today
